Renewable Energy Software Development: Digitizing the Energy Transition
Introduction
Kacper Gazda is the CEO of Milo Solutions, where he scopes and oversees custom software builds, including the industrial energy platform described in this article.
Most of what you will read about renewable energy software development is a benefits list: dashboards and AI-driven forecasting. This article is the opposite: a list of constraints, in the order they determine whether a build succeeds.
These projects live or die on four things that come before any dashboard: getting data off field devices, securing the rights to use that data, staying operational when the connection drops, and complying with market and reliability rules. Scope those four first and the analytics layer becomes a normal engineering problem.
US developers plan to add 86 GW of utility-scale capacity in 2026, including 43.4 GW of solar and 24 GW of battery storage, per EIA figures reported by PV Magazine USA. Every one of those megawatts arrives with equipment your software has to talk to.
In this article:
- 1. Key takeaways
- 2. Why this is not a normal software project
- 3. Getting data off the assets
- 4. Who owns the data
- 5. Sites are remote, and links drop
- 6. Time-series data at scale
- 7. The grid pushes back, and the rules push harder
- 8. Forecasting, honestly
- 9. Security decided at the architecture stage
- 10. The standards you will meet, in one table
- 11. How to tell whether a renewable energy software development partner knows the domain
- 12. Frequently asked questions
- 13. Sources
Key takeaways
- Field data acquisition, data access rights, connectivity and market rules drive cost and schedule; dashboards and forecasting are downstream of all four.
- Only 13% of the capacity that entered US interconnection queues between 2000 and 2020 reached commercial operation, so the software has to survive attrition and long timelines.
- Ride-through performance (PRC-029-1) and FERC Order 2222 participation now carry compliance dates, which makes them feature specifications.
- The fastest way to evaluate a development partner is to ask what happens after the API call works.
Why this is not a normal software project
In a typical product build, the specification is negotiable: an expensive feature gets cut or reshaped until the budget closes. In energy, the hard requirements come from outside. Field devices behave however their firmware dictates, and grid physics and market rules are just as indifferent to your budget.
The commercial environment is equally unforgiving. Berkeley Lab's Queued Up 2026 edition counts over 2,060 GW of generation and storage capacity waiting in US interconnection queues across roughly 8,200 projects. Of the capacity that requested interconnection between 2000 and 2020, only 13% had reached commercial operation by the end of 2025, and 75% was withdrawn; for projects that came online in 2025, the median wait exceeded five years.
Software scoped for this sector has to price that in: a platform can sit idle for years before the site energizes, and the portfolio it finally serves will not match the pitch deck.
Getting data off the assets
Every architecture diagram starts with a box labeled "device data," and filling it is the line item teams most consistently underestimate. Utility-scale sites use a mix of Modbus, DNP3 (IEEE 1815), and OPC UA, and every inverter OEM implements its Modbus register map differently. SunSpec Modbus exists because that fragmentation was unmanageable: an open DER information model, referenced in IEEE 1547-2018 as a compliance path. Above the wire protocols sits IEC 61850, a semantic data model defining 808 standardized data objects and 115 functions for utility automation. It describes what a measurement means rather than how the bytes travel, and confusing it with a transport protocol is a reliable sign a vendor has never used it.
Milo's device-data experience comes from industrial energy rather than renewable generation: an Onan emissions and energy-management platform for offshore drilling rigs, integrated through Kongsberg K-IMS, the vendor monitoring layer in front of the equipment.
We did not communicate directly with PLCs over Modbus, OPC UA, or MQTT. Kongsberg K-IMS acted as the rig monitoring and integration layer, and we consumed its data through a REST API with rate limits.

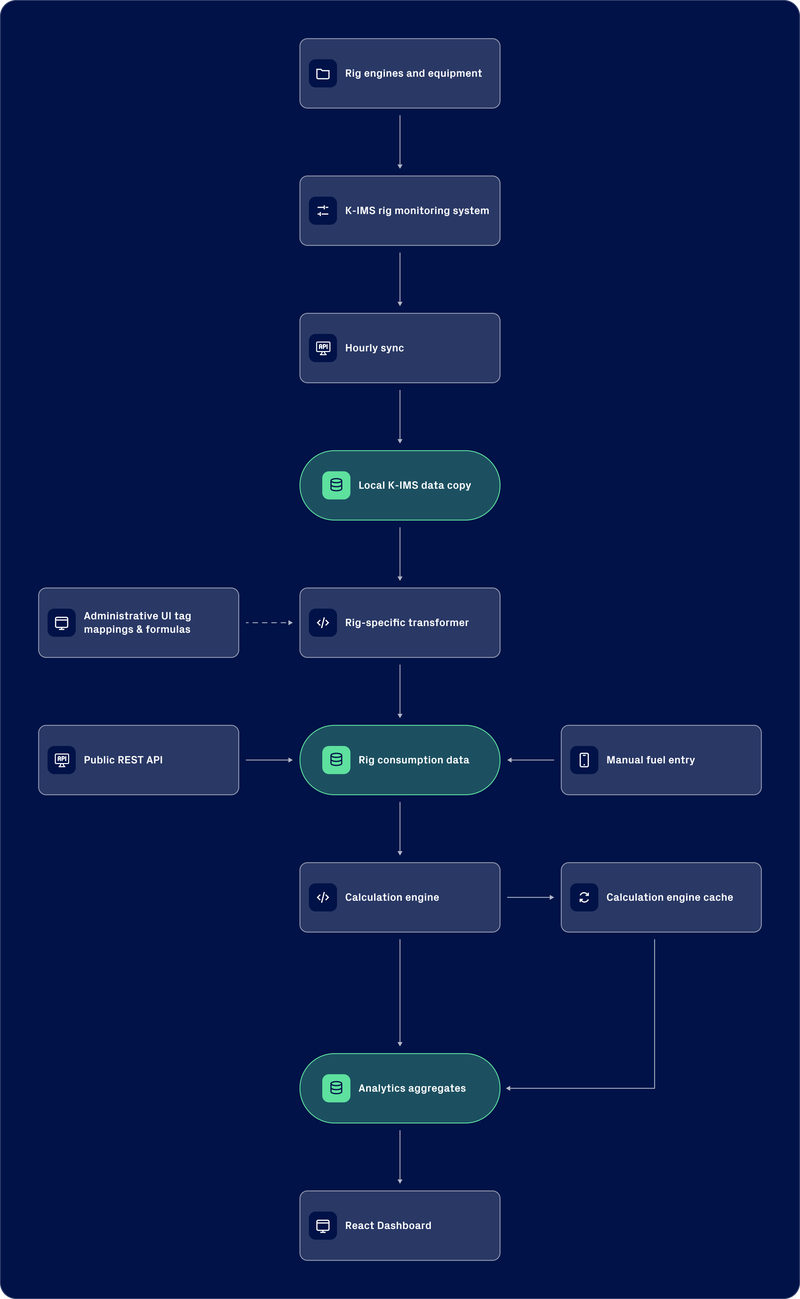

We synchronized relatively low-level engine and equipment telemetry, stored a local copy, and transformed selected tags into values such as rig fuel consumption and emissions. The mappings and transformation formulas were configurable separately for each rig through an administrative UI, so the client's staff could configure or adjust a rig without Milo changing code or deploying anything. Once data access was available, adding a new rig from our side could take as little as 15 minutes.
The K-IMS documentation was generally useful, but it did not cover everything we encountered in production, so sometimes we had to inspect the actual responses and work things out ourselves. At one point, the API changed without notice, causing measured fuel consumption and emissions data to stop appearing until we identified and adapted to the change.
That 15-minute figure was the payoff of a design decision: the first integration carried the raw store and mapping configuration, plus the admin UI that later rigs reused. Budget the first vendor integration in weeks and every later one in hours, and treat documentation as a hypothesis to test against live responses.
Who owns the data
The blocker nobody scopes for is contractual. Data coming off a turbine or an inverter passes through several hands, and each may control a piece of it:
- the asset owner, who assumes it is theirs
- the OEM, whose SCADA actually collects it
- the EPC that commissioned the site
- the O&M provider, whose service contract often defines who sees what
Teams tend to discover this weeks in, when the integration is ready, and the credentials are not, and no engineering resolves a contract. We hit a version of it on the rig platform, where approval set the onboarding timeline.
Access to K-IMS data was controlled by the client or rig operator and required approval. In practice, that external approval could take much longer than the technical configuration on our side, which could be done in around 15 minutes once access was available.
We therefore supported multiple ingestion paths. In addition to automatic K-IMS synchronization, clients can send fuel consumption data directly to our public REST API or enter it manually via the UI.
That meant we could first onboard a rig manually and later switch it to automatic telemetry once the necessary approvals were in place. It also allowed us to support rigs that were not using equipment covered by the K-IMS integration.
The design consequence generalizes: plan more than one ingestion path from the start, because manual entry and a public API stop looking like afterthoughts the day an approval stalls in legal.
Sites are remote, and links drop
Renewable sites sit where the resource is, which is rarely where the fiber is. Backhaul is cellular or satellite, and links drop. Hence, the software has to decide in advance what will keep working locally when the cloud disappears: anything that protects equipment or meets a grid obligation belongs on-site, while anything that only informs a human can wait. The harder engineering starts when the connection returns, because you have gaps to fill and duplicates to reject, and the upstream source may have revised its values in the meantime.
On the rig platform, we did not own the edge layer, but the synchronization followed the same physics.
We did not rely on a permanent live connection to the rig. A Celery job ran hourly and synchronized measurements incrementally, fetching data since the previous synchronization point.
We also built explicit recovery and reconciliation tools. If K-IMS data was missing, invalid or later corrected, an operator could refetch a selected historical period and choose either to fill only missing values or overwrite values that were already stored.
K-IMS was already the on-site monitoring layer in this project, so we did not build our own edge service on the rigs. Our responsibility was to make the synchronization recoverable and to ensure that temporary failures or corrected upstream data could be handled cleanly.
That separation paid off when the upstream API changed without notice: measured data stopped appearing while the rest of the platform kept running until we adapted. An external integration should fail without taking the product down.
Time-series data at scale
The arithmetic escalates faster than intuition suggests. On the rig platform, we tracked only 10 to 12 relevant telemetry tags per rig at hourly resolution, which still meant roughly 87,600 to 105,120 source values per rig per year before refetches. A utility-scale solar site runs hundreds of inverters, each exposing dozens of registers, often sampled every second. Even with an across-the-board modest portfolio of billions of points a year, a naive relational schema stops answering queries long before the first anniversary.
Operating cost follows from retention and downsampling: how long raw data stays queryable at full resolution, and which aggregates are precomputed. We stored the raw source copy separately from the transformed values, which is what made reconciliation and auditing possible later, and I would repeat that choice at any scale. The storage design either makes the analytics layer possible or quietly rules it out, a pattern we cover in our guide to enterprise web development.
The grid pushes back, and the rules push harder
Vendor pages describe software that reads from the grid; increasingly the grid writes back, and the rules carry dates and penalties.
Curtailment and setpoint control are feature areas
CAISO curtailed 3.4 million MWh of solar and wind output in 2024, 29% more than in 2023, with solar accounting for 93% of the total, according to the US Energy Information Administration. Current-year numbers are available in CAISO's monthly renewables performance report; for the asset owner curtailment is lost revenue. For the software, the specification is to accept a reduced setpoint on command and record why, then quantify the production loss, because that number feeds settlement disputes and PPA reporting.
Ride-through is now a compliance obligation
Inverter-based resources have a documented record of dropping offline during grid disturbances: nearly 1,200 MW of solar lost in the 2016 Blue Cut Fire event, 2,555 MW in the June 2022 Odessa event, and 921 MW across nine solar facilities in southwest Utah in April 2023, all recorded in NERC's inverter-based resource reference guide. FERC Order No. 909, published in the Federal Register in July 2025 and effective August 28, 2025, approved reliability standard PRC-029-1, which makes voltage and frequency ride-through mandatory for inverter-based resources from October 1, 2026 under NERC's implementation plan. Settings management and disturbance evidence retention are now software problems with an enforcement mechanism behind them.
FERC Order 2222 sets your market roadmap
If the product aggregates distributed energy resources into wholesale markets, FERC Order No. 2222 is the governing rule. Aggregations as small as 100 kW can participate, and each RTO implements on its own schedule, published in FERC's Order 2222 explainer. The schedule decides which market you can enter and when.
| RTO/ISO | Milestone | Date |
|---|---|---|
| CAISO | Implementation complete | November 2024 |
| ISO-NE | Capacity auction, then energy and ancillary services | February 2026, then November 1, 2026 |
| NYISO | Full implementation | End of 2026 |
| PJM | Capacity market, then energy and ancillary services | February 1, 2027, then February 1, 2028 |
| MISO | Phase 1, then phase 2 | June 1, 2027, then June 1, 2029 |
| SPP | Implementation | Second quarter of 2030 |
Forecasting, honestly
"AI forecasting" on a vendor page tells you nothing until two questions are answered: what data goes in and how error is measured? The inputs are mostly public and free: NREL's National Solar Radiation Database provides satellite-derived irradiance (GHI, DNI, and DHI) at resolutions down to 5 minutes and 2 km, and NOAA's HRRR model delivers 3 km numerical weather prediction, updated hourly with radar assimilated every 15 minutes, out to 36 hours. The real engineering is the ingestion pipeline and the backtesting setup that scores every forecast against what the site produced.
The right model is sometimes plain arithmetic. The rig platform's forecasting was deterministic by design: we took a baseline from historical consumption, applied the expected effect of each planned reduction initiative, and compared the target against measured data as it arrived hourly. A target the client could audit served accountability better than a machine-learned one they could not inspect. Pick the model class after you know what question the forecast has to answer.
Security decided at the architecture stage
Whether the asset is NERC-registered is the first scoping question, because the answer changes the architecture. Assets on the bulk electric system fall under the NERC CIP reliability standards, which address network segmentation, remote access, patching, and logging. Retrofitting segmentation into a flat network is a rebuild, so ask the registration question before anyone draws the network diagram. At the small end, NIST IR 8498 provides seven practical cybersecurity guidelines for residential and light-commercial smart inverters, a sensible floor for DER products that will never undergo a NERC audit.
The standards you will meet, in one table
Every row below has stopped a sprint somewhere.
| Standard | What it governs | Where it shows up |
|---|---|---|
| IEEE 1547-2018 | US DER interconnection, with a mandatory communications interface | Any US DER product; certification is schedule risk |
| IEC 61850 | Semantic data model for utility automation: 808 data objects, 115 functions | Substation and DER integrations |
| IEEE 1815 (DNP3) | SCADA communications with field devices | Utility control-center integrations |
| SunSpec Modbus | Open DER information model over Modbus | Inverter and meter integration |
| IEEE 2030.5-2023 | RESTful utility management of end-user energy | California CSIP deployments, DER aggregation |
| OpenADR 2.0b and 3 | Demand response signaling | Utility DR programs |
| OCPP 1.6 / 2.0.1 / 2.1 | EV charger to management system | EV charging networks |
| Green Button / NAESB ESPI | Customer energy usage data exchange | Retail energy products |
| NIST IR 8498 | Smart inverter cybersecurity guidelines | Residential and light commercial DER |
How to tell whether a renewable energy software development partner knows the domain
The test I apply to any renewable energy software development partner, including my own company, is whether they can tell you where their experience ends. Here is mine, as I would state it in a scoping call.
I can speak directly about a project: an emissions and energy-management platform for offshore drilling rigs. We worked with K-IMS telemetry, operational modes, fuel consumption and emissions calculations, historical baselines, and Emission Management Plans that compared expected reductions with those actually measured on the rig. That gives us direct experience with industrial telemetry and operational energy use. Still, I would not use this project to claim experience with renewable-generation controls, VPPs, battery dispatch, or direct PLC integrations over protocols such as Modbus or OPC UA. I also do not know Milo's other projects well enough to make broader claims on their behalf.
The admission tells you what a partner would be learning on the job, and the transferable core (telemetry ingestion, reconciliation, configurability) is what most of these builds depend on anyway. It also shapes what I tell clients about where scoping goes wrong.
What is often underestimated during scoping is everything that has to happen once the integration is running against real operational data. The calculations themselves can be difficult (they were in our case), but you also need to decide what happens when data is missing, corrected later, or temporarily unavailable; when access approvals take longer than expected; when the API is rate-limited; or when the vendor changes the API without notice.
The part clients tend not to scope properly is what happens after the API call works. In our case, we needed historical refetching, reconciliation, recovery after failed synchronization, and sufficient configurability for the client's own staff to add or adjust rigs without involving developers. Those things are easy to treat as edge cases at first, but they become part of the system's normal operation.
When turned into interview questions, it separates a partner who has operated one of these systems from one who has only read about them.
| Question to ask | What a credible answer sounds like |
|---|---|
| How do you handle a vendor changing its API without notice? | A containment story: the integration failed alone and the product kept running |
| What happens when historical data is corrected upstream? | A refetch mechanism with an explicit fill-or-overwrite choice |
| Who configures a new site or device, your developers or our staff? | Configuration exposed through an admin UI, with a number attached |
| Which date of FERC Order 2222 applies to our market? | Your RTO named, with capacity and energy dates distinguished |
| What do you log when output is curtailed? | The setpoint order, the cause and the lost production |
Weighing partners this way follows the same logic we use when choosing an MVP development company: evidence of handling specific failure modes beats the breadth of claims.
Keep one ordering from this piece: data acquisition, data rights, connectivity and compliance come first, and the dashboard and forecasting are downstream of all four. Scope in that order, and the impressive parts get built on something that stays up.
Frequently asked questions
What is renewable energy software development?
It is custom software for renewable generation and storage operations, including monitoring, asset management, forecasting, market participation, and compliance tooling. It differs from standard application work because field devices, grid physics and market rules act as external specifications the build has to satisfy.
How long does it take to integrate a new device or site?
Once a data path and access rights are in place, configuration can take minutes; our record on an industrial telemetry platform was about 15 minutes per rig. The first integration takes weeks because it builds the tooling that later ones reuse, and access approvals often take longer than the engineering work.
Do we need to comply with FERC Order 2222?
Only if the product aggregates distributed energy resources into wholesale markets.
The compliance date depends on the RTO:
- CAISO is live now
- PJM's dates are February 2027 and February 2028
- MISO's are June 2027 and June 2029
- SPP arrives in 2030.
