Software outsourcing services: a founder's guide to getting it right

Introduction

Software outsourcing services range from lending you two engineers to running your product roadmap, and the difference between those arrangements decides who carries the risk when something goes wrong. This guide covers the whole decision: whether to outsource, which model to use, what it costs, how to pick a partner, and how these relationships come apart. I have run outsourced engagements for years, including one that started with a single developer and now spans two platforms and fifteen people.

Key takeaways

  • Outsourcing earns its place when the real constraint is speed or a missing skill set, or when an in-house team needs reinforcement. It goes wrong when it is used to avoid making a technical decision.
  • Match the engagement model to your planning horizon: three to six months if you are early, two to five years if the business is established.
  • Commissioned software is not automatically yours under US copyright law. Ownership passes through a written assignment, so read that clause before anyone writes a line of code.
  • Almost every broken engagement I have inherited began with a vendor chosen in under a week.

What software outsourcing services actually cover

Software outsourcing means paying an external company to design, build, test, or maintain software that you own. Three terms sit underneath that label and get used interchangeably even though they behave very differently, which is where most of the confusion starts. Staff augmentation places individual engineers within your team and leaves you managing them day-to-day. Offshoring refers to where the work happens, rather than to how the contract is structured, so that an offshore team can be a dedicated team, augmented staff, or a fixed-scope supplier. Managed or outcome-based delivery hands over responsibility for the result rather than for hours, and the vendor absorbs the risk of getting there.

The market is large and still growing: Grand View Research estimates global IT services outsourcing at $744.6 billion in 2024 and projects it will reach $1,219.31 billion by 2030, with a compound annual growth rate of 8.6% from 2025, with North America holding over 32% of the 2024 total. Gartner's July 2026 forecast has worldwide services spending reaching $1,570 billion in 2026, up 5.3%, inside total IT spending of $6.37 trillion.

Those headline numbers hide the part that matters to a founder. The ISG Index for full-year 2025 reported managed services annual contract value of $43.4 billion, up 1.3%, the slowest growth since 2020, against cloud and XaaS spending of $84.0 billion, up 29%. ISG counts only commercial outsourcing contracts worth $5 million or more a year, so every engagement a 20-person company will ever sign sits below that line and never appears in the figure. When you read that outsourcing is slowing, check whether the number describes a market you are actually in.

Should you outsource software development at all?

Outsourcing is the right answer when the constraint is capacity or the calendar, or when the missing piece is a skill your team does not have and does not need permanently. It is the wrong answer when the thing you are trying to hand over is the decision itself.

Here is when I tell founders it makes sense:

When you want to build a product quickly.

When you want to speed up an in-house team.

When you have no tech knowledge and can't own hiring an engineer yourself.

That third case is the one people argue with, and it is the one I see most often. A non-technical founder who tries to run hiring on their own usually spends four to six months learning what a good engineer looks like and pays for the education twice.

The in-house alternative has a published price. The US Bureau of Labor Statistics reports a median annual wage of $133,080 for software developers as of May 2024, with employment projected to grow 16% between 2024 and 2034. Add employer taxes, benefits, equipment, recruiting fees, and the months a role sits open, and the loaded cost of one senior engineer in a US market comfortably clears $180,000 a year before they ship anything.

Cost is no longer the only reason companies do this, and it has not disappeared either. Deloitte's 2024 Global Outsourcing Survey of more than 500 business and technology leaders, including over 150 C-suite executives, found that 34% cited cost savings as the main reason for outsourcing, down from 70% four years earlier and from 40% to 57% two years earlier. Deloitte's own framing is that businesses now prioritize talent, service quality, global delivery, and agility in addition to spend optimization.

Keep the work in-house when the software is what makes your company different and the knowledge has to compound inside your walls, which is why a payments company should own its risk engine and has no reason to own the internal admin tool that three people use.

Which engagement model fits you?

The model determines who bears the risk and who plans the work, and what happens when the scope changes. Choosing it by price is how founders end up with a contract that fights them for two years.

The model you choose should align with the goals you have for the next three to six months (early-stage businesses) or the next two to five years (more mature businesses).

That horizon test does more work than any comparison chart: if you cannot describe what the product needs to be in six months, a fixed-scope contract will start generating change requests in week three. If you can describe a two-year roadmap, paying for a team that learns your domain is cheaper than re-briefing a new supplier every quarter.

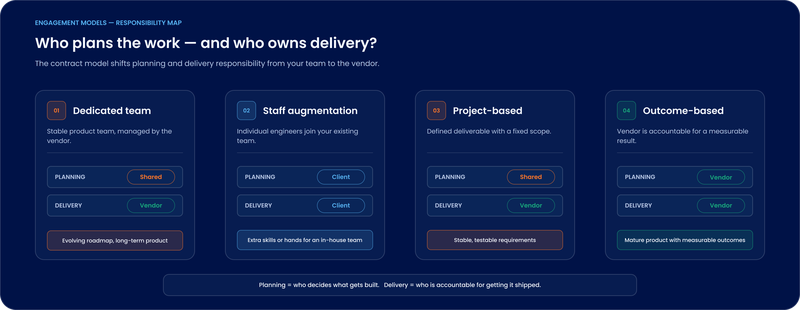

Model What you are buying Best fit Main risk
Dedicated team A stable group working only on your product, managed by the vendor A roadmap measured in years, evolving scope You still need someone senior on your side setting priorities
Staff augmentation Individual engineers who join your existing team An in-house team that needs specific skills or extra hands Management overhead lands entirely on you
Project-based, fixed scope A defined deliverable for a defined price A well-specified build with stable requirements Change requests, and an incentive to finish rather than to finish well
Managed or outcome-based Responsibility for a result, measured against agreed outcomes Mature products with measurable service levels Defining the outcome precisely enough to be enforceable

Outcome-based arrangements have moved from niche to the norm: Deloitte's 2024 survey found that 67% of executives are adopting outcome-based outsourcing relationships, continuing a shift away from traditional staff augmentation. That shift only helps you if the outcome can be written down and measured, which rules out most early-stage products.

At Milo, we run one model: a dedicated development team, and we size it to the problem instead of to a minimum contract.

We do not have ranges set; we can even start with one person and PM support and grow if needed.

If you want the detail on how a dedicated team is structured and staffed, I have written that up separately in our guide to dedicated software development teams.

Outsourced product development guide covers the version where a vendor takes on product responsibility as well as delivery.

What does software outsourcing cost?

I will not publish a rate card, and I want to be straight about why.

It's highly individual; it all depends on the team members' seniority, experience, and stack. I would avoid talking about cost ranges publicly.

A single hourly number tells you almost nothing, because the same rate buys wildly different outcomes depending on who is behind it. The market's shape is more useful, and several independent sources publish it.

Region Junior hourly rate Senior hourly rate
Europe $31 to $39 $64 to $76
Latin America $33 to $45 $60 to $75
Asia $24 to $31 $31 to $41

Those bands come from Accelerance's 2026 rate analysis, based on its survey of 60 development partners, so treat them as a sample rather than a census. Clutch's pricing guide, updated 26 July 2026, reports bands observed across self-reported vendor profiles instead of surveyed rates, and lands in a similar place: $50 to $99 an hour for United States and Polish firms, $100 to $149 for Canadian ones, and $25 to $49 for Ukrainian and Indian ones. The two sources disagree by a wide margin in places, which is the point: anyone quoting you a single global figure is guessing.

Compare any of that against the $133,080 US median above and the arithmetic looks obvious, until you count the parts nobody quotes. Ramp-up is real time on the invoice before real output appears, and somebody on your side has to specify, review, and accept the work, usually your most expensive employee. Churn inside the vendor resets knowledge you already paid to build, and rework caused by a vague brief is billed at the same rate as the original build.

A useful discipline is to budget the first three months as learning costs and judge velocity from month four onward. For a full breakdown of how these variables move a build budget, see MVP development cost guide.

Does location still matter?

Location matters less than it used to on cost and more than it used to on everything else.

Time zone overlap is the constraint founders underestimate. A Central European team and a US East Coast team share a workable window in the European afternoon. Stretch that to the US West Coast and the overlap thins until decisions queue overnight, which is survivable on a maintenance contract and painful during discovery.

Legal jurisdiction matters more than a rate difference of a few dollars, because enforcing an IP assignment in a country with no reciprocal enforcement is a theoretical remedy. Ask where the contracting entity is registered, and treat that as a separate question from where the developers sit.

Talent depth is the third factor and the least visible from outside. A region with a deep pool absorbs a resignation without a gap, while a small supplier in a thin market cannot replace a departing specialist, whatever the contract says. [insert link: Software development companies in Europe, row 25] goes into the regional detail.

How do you choose a partner without getting burned?

There are two things I look at, and neither of them is a portfolio.

Transparency and record of success. Talk with current and previous clients.

Previous clients matter more than current ones, because a vendor will hand you references who are three months into a honeymoon. Ask instead for two clients whose engagements have ended, and ask them why. The answer, and the vendor's willingness to make the introduction at all, tells you more than any case study on a website, including mine.

Green flag Red flag
Will introduce you to former clients as well as current ones Only offers references from live, recent engagements
Shows you a running deployment pipeline and a real repository Talks about process without showing you the tooling
Names the specific engineers who will work on your product Sells you a team and staffs it after you sign
Asks uncomfortable questions about your scope before quoting Quotes within 48 hours on a one-page brief
Writes down what happens when scope changes Treats change control as a conversation to have later
Hands over code and credentials continuously from day one Holds the repository and grants access on request

Then ask to see a live deployment: an actual pipeline running against an actual product, rather than a slide describing one. A team that ships continuously can show you that in five minutes, and a team that cannot will explain why today is inconvenient.

Treat vendor failure statistics carefully, starting with the Standish Group's 2020 CHAOS Report, which reports 31% successful, 50% challenged, and 19% failed. Varajão and Trigo show in ACM Queue that the sample and method behind those numbers have never been published.

The same authors criticize CHAOS for nondisclosure of the methodology and the data collection instrument, no explanation of how participants were selected, and inconsistent reporting. Their own study, based on 193 usable responses from experienced IT project managers, found 90.16% rating their projects above the midpoint of the success scale. Two credible sources paint opposite pictures, which is a good reason to choose a partner based on verifiable references and ignore the percentage in the sales deck.

Where public numbers do hold up, they are worth reading carefully. The US Government Accountability Office reviewed 24 Department of Defense IT business programs in a June 2025 assessment and found 12 reporting cost increases ranging from $6.1 million to $815.5 million, with a median of $173.5 million, and 7 reporting schedule delays of 3 to 48 months, with a median of 15 months. Those are contractor-delivered systems bound by procurement rules far stricter than anything you will sign, so overruns are clearly not a small-vendor problem.

Who owns the code, and when does that get decided?

Ownership gets decided before the first commit, in writing, or you may find the answer is not the one you assumed.

Selecting a bad provider due to hiring within one to three days will lead to technical debt, lost money, and lost time. Some founders do not even own their own IP or have access to the source code or any sources at all.

That last sentence usually describes a legal default rather than a scam. Under US copyright law, a commissioned work counts as a work made for hire only if it was specially ordered or commissioned for use as one of nine enumerated categories, and both parties signed an express written agreement saying so. The US Copyright Office Compendium lists those categories: a contribution to a collective work, a part of a motion picture or other audiovisual work, a translation, a compilation, a test, answer material for a test, an atlas, an instructional text, and a supplementary work. None of the nine is written for software.

The practical consequence is that ownership of commissioned software normally transfers by written assignment, and if no assignment was made, the developer may still hold the copyright. The Compendium is explicit that the agreement must be express, written, and signed by both parties. A verbal understanding and a paid invoice do not add up to ownership.

Four things belong in the contract and in your possession from week one:

  • an assignment of all intellectual property in the deliverables to your company
  • administrative ownership of the source repository, which is a stronger position than having access to it
  • your own accounts for hosting, domains, and third-party services
  • written handover of build and deployment instructions

If a vendor pushes any of those to the end of the project, you have your answer.

How engagements fail, and what it looks like before they do

Both sides usually see it coming weeks out, and neither says anything. The signals are consistent:

Communication is inconsistent; there is no transparency about who is doing the job, no clear planning, no tools used to set up management, and no proper kick-off meeting. More talk than work provided by the team.

Every item on that list is observable inside the first two weeks. There was no kickoff with named people and agreed-upon goals, and standups happen when someone remembers. You cannot tell from the board who is working on what. Nothing is planned beyond the current week, and the status update runs longer than the changelog.

The fix is unglamorous, but it works: run a real kick-off with every named person in the room. Agree the tools before the work starts and insist all work lives in them, so progress is visible without anyone having to ask for it. Set a weekly written update that reports what shipped rather than what was discussed. Give the vendor one decision-maker on your side who can answer within a day, because a blocked question is the most expensive item on any invoice.

The satisfaction data suggest that most engagements fall somewhere in the middle. Whitelane Research's 2025/2026 European IT Sourcing Study, covering more than 2,500 organizations and close to 7,000 sourcing relationships, reported average satisfaction of 76%, its highest to date, while one in five respondents planned to reduce spending on external providers within two years. Both findings hold at once, which matches what I see: plenty of adequate relationships and fewer genuinely good ones, alongside a steady group of companies quietly deciding it is not working.

What a long-running engagement actually looks like

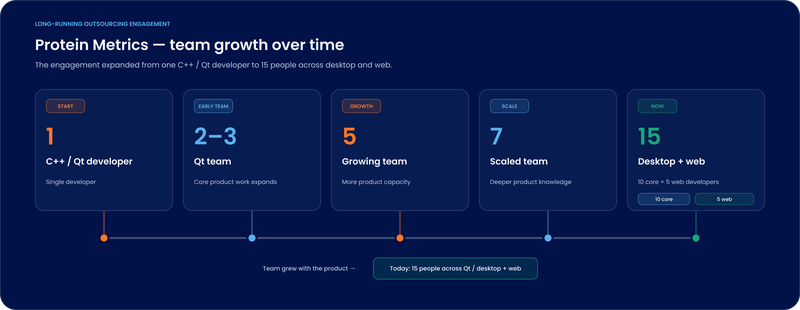

Protein Metrics is our longest-standing client. Their software, Byos, handles protein characterization and quantification from mass spectrometry data for biopharmaceutical research, and it runs on desktop and web platforms. It is scientific software with a small, expert user base and a very low tolerance for wrong answers.

We started with only the Qt team. A two- to three-member team. Then it grew to five, seven, ten. We now also support the app's web component and have engaged five web software developers.

That progression is the honest shape of a long outsourcing relationship. There was no signed multi-year plan at the start, just a single C++ and Qt developer solving one problem, and it grew because the work kept being useful. The product is now used by more than 200 biopharmaceutical companies and 300 academic institutions, including AstraZeneca and GSK.

This situation was changing; it was a very long time ago, and it's hard to write about first steps. The team has proven very productive, as we have been cooperating for years now. The product is very complex.

I include that quote because the ramp-up story is the part vendors usually invent. The team is productive now because it has absorbed a complex scientific domain over many years, and in the first months it simply was not, because nothing would have made it so. If a supplier promises full productivity in week two on a complex product, they are describing a simpler product than yours.

Frequently asked questions

What is the difference between software outsourcing and staff augmentation?

Outsourcing hands off a defined piece of work or a whole product to an external company that manages delivery. Staff augmentation places individual engineers into your team and leaves the management with you. The distinction determines who is accountable when a deadline is moved.

How much does it cost to outsource software development?

Accelerance's 2026 figures put senior engineers at $31 to $41 per hour in Asia and $60 to $76 per hour in Europe and Latin America, while Clutch's marketplace data commonly show $50 to $99 per hour for United States firms. Compare those against the US median software developer salary of $133,080, then add ramp-up, your own management time, and rework.

Do I own the code my outsourcing partner writes?

Only if your contract says so in writing; none of the nine statutory categories for commissioned works made for hire apply to software, so ownership normally has to be transferred by a signed assignment; get repository administration and credentials simultaneously.

What is the biggest mistake founders make when outsourcing?

The most expensive mistake is choosing a supplier too quickly. A vendor selected in one to three days has not been reference-checked, and the cost arrives later as technical debt and lost time, and sometimes as lost ownership of the code.

How long before an outsourced team is productive?

That depends more on the complexity of the domain than on the seniority of the engineers. Simple products can reach useful output in two to four weeks, while complex ones in regulated or scientific fields take months, and any supplier promising otherwise is guessing.

Sources

Disclaimer

This article discusses contract and intellectual property matters in general terms and reflects my experience running software engagements. It is not legal advice. Copyright and contract law differ by jurisdiction, and you should have a qualified attorney review any IP assignment, confidentiality, or service agreement before you sign it.
